How Long Does a Roof Replacement Take? A Day-by-Day Look

By Robert Shelby · August 24, 2026 · 14 min read

A completed residential roof replacement on a large North Georgia home, shown from above by Platinum Roofing

The most common question I get once a homeowner decides to move forward is not about price. It is about time. How long will my roof take, how many days will there be a crew at my house, and how much of a mess is this going to be. Those are fair questions, and the honest answer is better than most people expect. I am Robert Shelby, owner of Platinum Roofing and a fourth-generation roofer, and I want to walk you through exactly what a replacement looks like from start to finish so you know what to plan for.

Here is the headline: most homes in our part of North Georgia get a complete roof replacement done in a single day. You leave for work with an old roof and come home to a brand new one. The bigger picture, from the day you sign to the day the crew pulls out, usually runs a week or two, and almost all of that is scheduling and materials, not hammer time. Let me break it down.

The Short Answer: Usually One Day on the Roof

For a typical single-family home in Canton, Woodstock, Marietta, or anywhere across our service area, the actual tear-off and new roof happen in one full working day. A larger home, a steep or cut-up roof, or a house that needs decking work can push into a second day, and a big custom home with a complex roofline might take three. But the single-day job is by far the most common, and it is what we plan around.

How many days will it take? Time on the roof, by home size (1 roofing square = 100 sq ft) Ranch, up to 20 squares 1 day 2-story, 20 to 30 squares 1 day Large or cut-up, 30 to 45 1 to 2 days Very large, steep, or 2 layers 2 to 3 days Most North Georgia homes are a single-day job.

The size of a roof is measured in squares, where one square covers 100 square feet. A common ranch might be 18 to 22 squares, a two-story home 24 to 32, and a large custom home 40 or more. The more surface area, the more hips and valleys, and the steeper the pitch, the longer the crew spends up there. When we give you your estimate, we tell you which category your home falls into so there are no surprises on the calendar.

Before Install Day: The Week or Two That Leads Up To It

The single day on the roof is the visible part. Here is what happens in the days before it, most of which takes zero effort from you.

We measure and finalize the scope. After your free inspection, we know your exact square footage, pitch, and facet count, and we know whether the decking or flashing needs attention. That becomes a fixed, written scope so the crew shows up with the right amount of everything.

We order your materials. Once you approve the color and shingle line, we place the order with our supplier. This is usually the longest single step, and it typically runs a few days to a week depending on the product. Special-order colors or premium lines can take a little longer, and we tell you up front if yours is one of them.

We pull a permit if your city requires one. Many North Georgia jurisdictions require a roofing permit. We handle that paperwork for you. It is part of doing the job right and it protects you at resale.

We schedule around the weather. Georgia gives us plenty of workable days all year, and we watch the forecast closely so your install lands on a dry window. Roofing goes on best over a clear, calm stretch, so if a storm is sitting on your install date, we will simply move you to the next good day. That is not a delay, it is us making sure your roof goes on under the right conditions the first time.

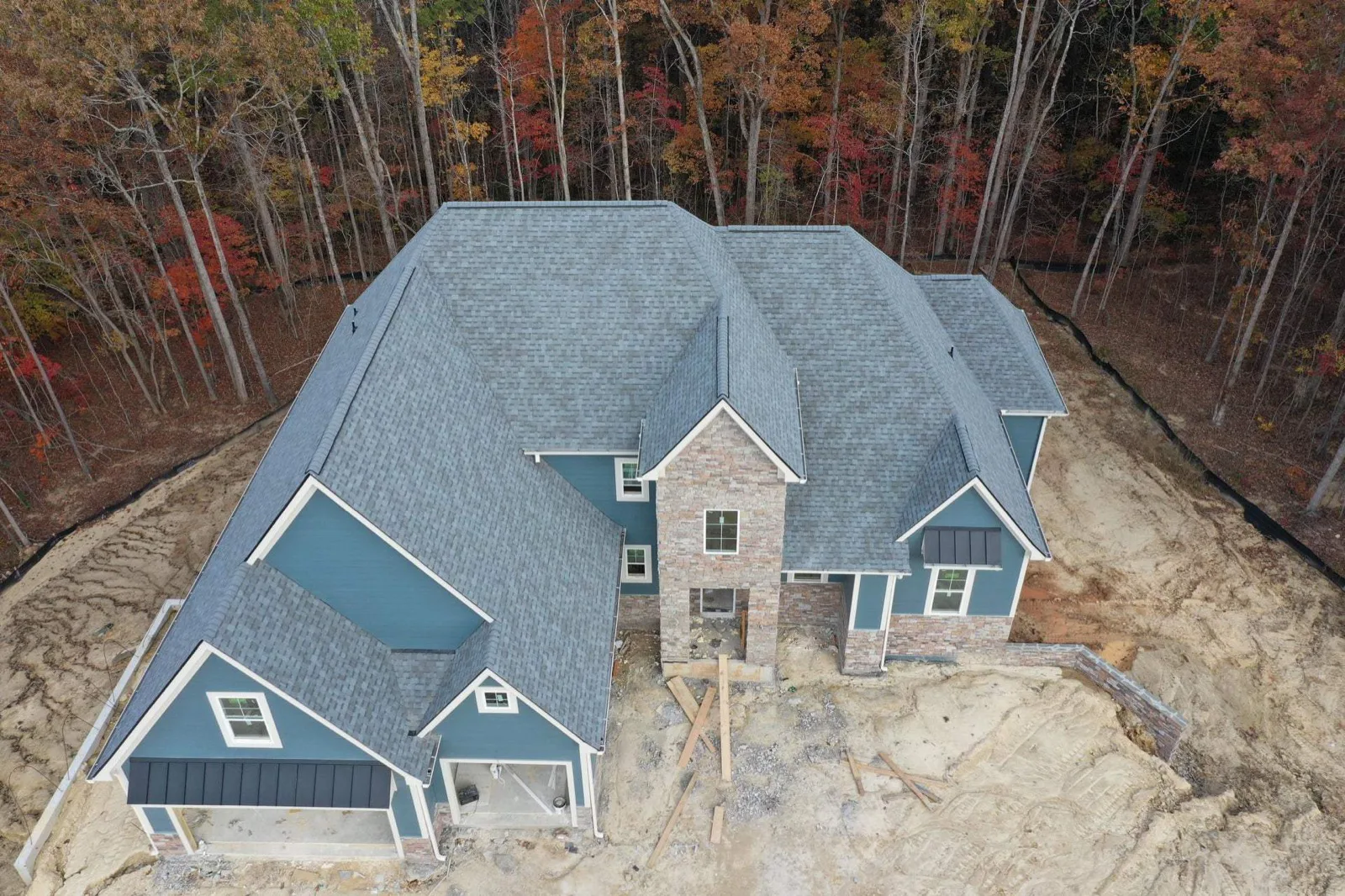

A large new build in North Georgia with a fresh architectural shingle roof installed by Platinum Roofing, viewed from above

Install Day, Hour by Hour

This is the day everything comes together. A full crew arrives in the morning and, on a typical home, your new roof is finished by evening. Here is how a single-day job flows.

A single-day roof replacement, hour by hour A typical North Georgia home. Times shift with size and weather. 7:00 am Arrive and protect the property Prep 8:00 am Tear off the old roof Tear-off 10:30 am Inspect the wood decking Check 11:00 am Underlayment and leak barrier Install 12:30 pm Drip edge, valleys, and flashing Install 1:00 pm Install the new shingles Install 4:30 pm Ridge cap and final details Finish 5:00 pm Clean up and magnet sweep Finish 6:00 pm Final walkthrough with you Done

Morning: setup and tear-off. The crew arrives early and the first thing they do is protect your home, not touch the roof. Tarps and ground protection go around the house to catch debris and shield your landscaping, siding, and windows. Then the tear-off begins. Old shingles, old underlayment, and old flashing come off down to the bare wood decking, and everything goes straight into the dump trailer.

Midday: inspection and dry-in. With the deck exposed, we inspect the wood. This is the part you cannot see from the ground and the reason a real tear-off matters. If any decking is soft or water-damaged, we replace those sections before anything new goes on. Then comes the dry-in: new underlayment across the whole roof and a leak barrier in the valleys and around every penetration. From this point your home is protected from weather even before the shingles are on.

Afternoon: shingles and finish work. Drip edge, flashing, and starter course go on, then the new shingles work their way up the roof, followed by the ridge cap and any pipe boots, vents, and details. When the last shingle is set, the crew does a full cleanup, runs rolling magnets across your entire yard and driveway to pick up every stray nail, and hauls off the trailer. Before they leave, we walk the property with you so you can see the finished job and ask anything you want.

How We Protect Your Home While We Work

A roof replacement is a big job happening right over your head, and protecting everything below it is part of doing it right. Before a single shingle comes off, we cover the areas around your house so that tear-off debris lands on tarps instead of your flower beds, your deck, or your AC unit.

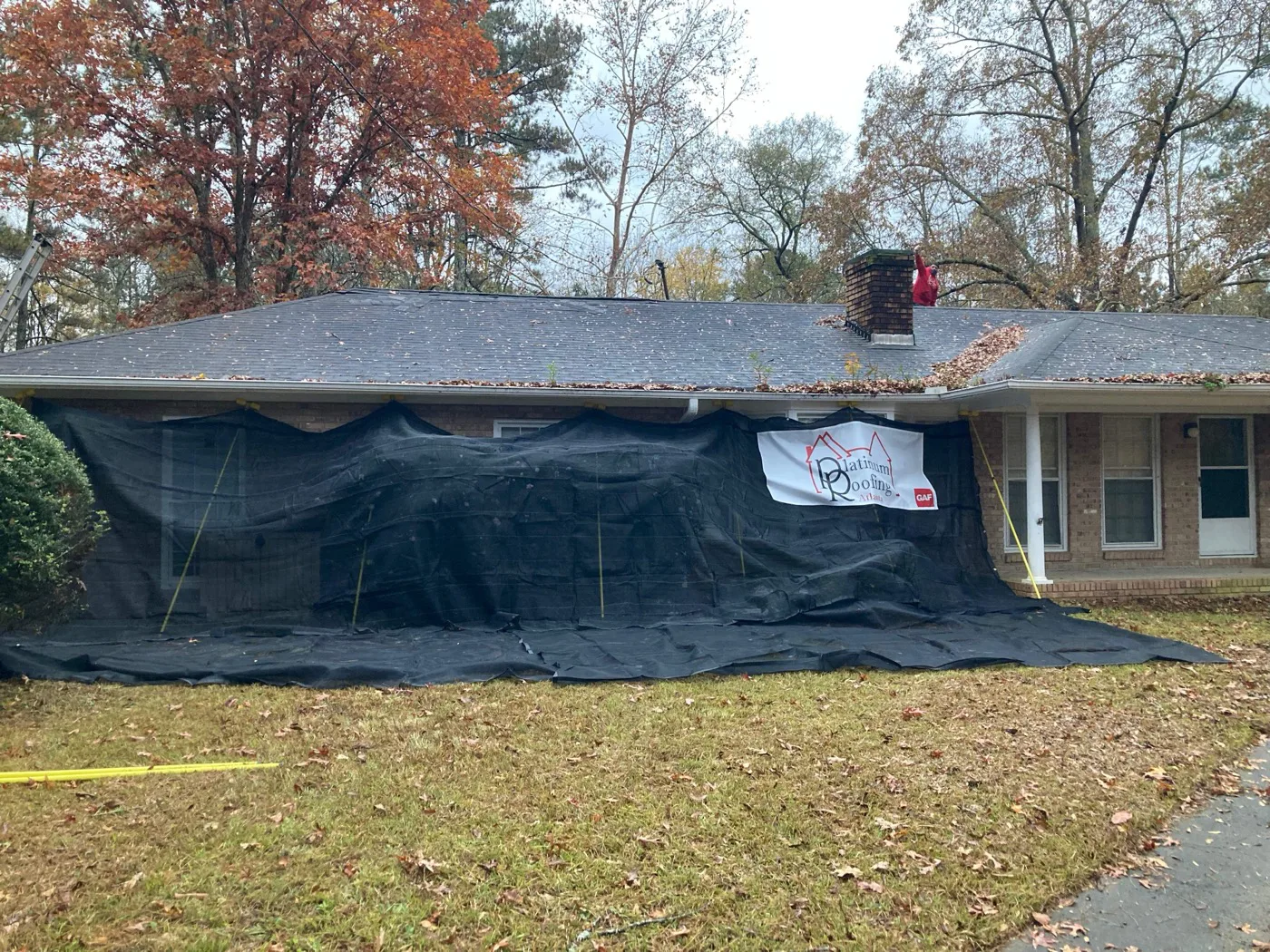

A North Georgia home with protective tarps draped over the landscaping and porch during a Platinum Roofing tear-off, with the company banner displayed

That photo is a real job of ours, and it shows exactly what property protection looks like partway through a tear-off. The magnet sweep at the end matters just as much. Loose roofing nails in a yard are the number one complaint people have about the roofer they used before us, so we run magnets across the lawn, the driveway, and the walkways until they come back clean. You should be able to let kids and pets back into the yard the evening we finish.

What Makes a Job Take Longer Than a Day

Plenty of roofs are done by dinnertime, but some honestly need more time, and it is better to know why up front. Here are the things that add hours or a second day.

Size and complexity. A big house with lots of surface area simply has more roof to cover. Add in multiple hips, valleys, dormers, and a cut-up roofline, and the detail work multiplies. A large custom home can be a two-day or three-day job, and that is normal.

Steep pitch. A steep roof slows everyone down because the crew has to move carefully and use extra safety equipment. A walkable roof goes fast. A steep one takes longer for the same square footage, and that is a good tradeoff for doing it safely.

A second layer to remove. If your home already has two layers of shingles, that is twice the tear-off. It also usually means a heavier day at the dump trailer. We can see this during the inspection and build the extra time into the schedule.

Decking repairs. If we open up the roof and find rotted or soft decking, replacing it is the right call and it adds time. We never shingle over bad wood, because new shingles on a failing deck solve nothing. Our guide on repair versus replacement explains why the wood underneath drives so many roofing decisions.

Weather. If rain moves in during a multi-day job, we get the roof to a watertight dry-in state and pause until it clears. Your home stays protected the whole time. In our climate these pauses are usually short, and picking the right window is exactly why we plan the start date around the forecast.

After the Crew Leaves

The job is not finished when the last shingle is set. We do a final quality inspection, register your manufacturer warranty, and make sure the site is spotless. You get documentation of the completed work, which is worth keeping for your records and for resale. If anything needs a second look in the days after, we come back out. A roof is a long-term investment, and standing behind it after the trucks leave is the whole point.

A Platinum Roofing team member with two happy homeowners in front of their completed home in North Georgia

Ready to Get on the Schedule

The best part of a single-day replacement is how little it asks of you. One good weather day, a crew that protects your property and cleans up behind itself, and you are set for the next 25 years. If you want to know how your specific home fits the timeline, that is an easy question to answer.

Start with our instant roof quote: enter your address, we measure your actual roof from current aerial imagery, and you get the square footage, pitch, and a price range emailed to you in about a minute, with nobody visiting your home. When you are ready for the definitive plan, schedule a free inspection and we will confirm the scope, the material, and exactly how many days your roof will take.

We serve Canton, Woodstock, Holly Springs, Ball Ground, Jasper, Roswell, Alpharetta, Milton, Johns Creek, Marietta, Kennesaw, Acworth, and the rest of the eleven North Georgia counties in our service area. Call Platinum Roofing at (770) 419-5714, book your free inspection online, or get an instant quote. We have been putting on roofs since 2000, and we will get yours done right, and usually in a single day.

Frequently Asked Questions

How long does it take to replace a roof?

For a typical single-family home in North Georgia, the tear-off and new roof are completed in one full working day. A larger home, a steep or cut-up roof, or a house that needs decking work can run into a second day, and a large custom home with a complex roofline can take three. The bigger timeline from signing to completion is usually a week or two, and most of that is ordering materials and scheduling around the weather, not time spent on the roof.

Can a roof really be replaced in one day?

Yes, and it is the most common outcome. A full crew arrives in the morning, tears off the old roof, inspects and dries in the decking, installs the new shingles, and cleans up by evening. A single-day replacement is standard for an average-size home. Size, steep pitch, a second layer of old shingles, or decking repairs are the main reasons a job extends beyond one day.

What happens if it rains during my roof replacement?

We plan your install around the forecast to land on a dry window, so rain during the job is uncommon. If weather does move in during a multi-day project, the crew brings the roof to a watertight dry-in state, meaning new underlayment and leak barrier are already down, and pauses until it clears. Your home stays protected the entire time, and in our climate these pauses are usually short.

Do I need to be home when my roof is replaced?

You do not need to be home during the work. Many of our customers go to work as usual and come back to a finished roof. We do like to do a short walkthrough with you at the end so you can see the completed job, and we are always reachable during the day if a question comes up.

How do you protect my house and yard during the job?

Before any tear-off begins, we set tarps and ground protection around the house to catch debris and shield your landscaping, siding, windows, and AC unit. At the end of the day we run rolling magnets across the entire yard, driveway, and walkways to pick up stray nails, and we haul off all the old material. The goal is for your property to look untouched except for the new roof over it.

How long before I can schedule my replacement?

Once you approve the estimate, the main wait is ordering materials, which typically takes a few days to about a week depending on the shingle line and color. We pull any required permit and set your install for the next good weather window. If you want to know your home's timeline specifically, start with a free inspection or an instant quote.

Robert Shelby, General Manager

About the Author

Robert Shelby

Fourth-generation roofer who founded Platinum Roofing in 2000. Meet the Platinum Roofing team →
